Week 7/4/22 through Week of 8/29/22 – Progress Updates
- During July and August, construction work and activities included the following:

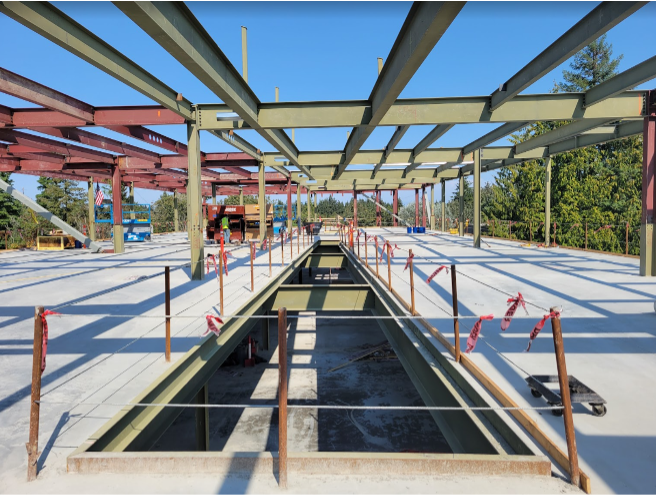

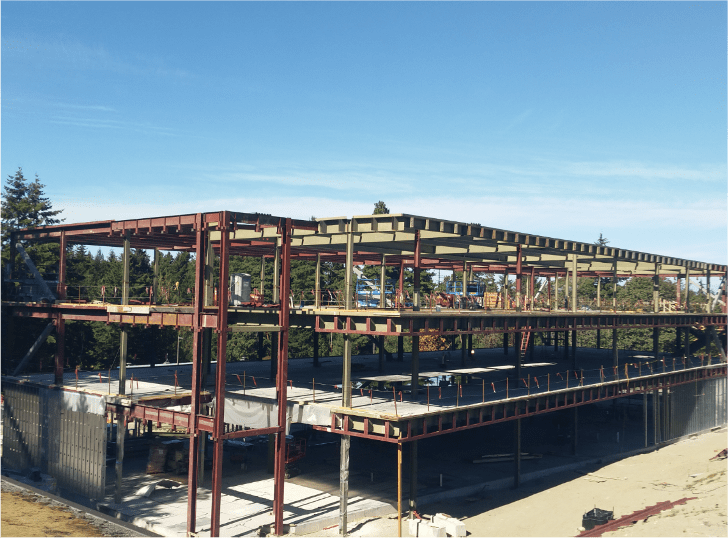

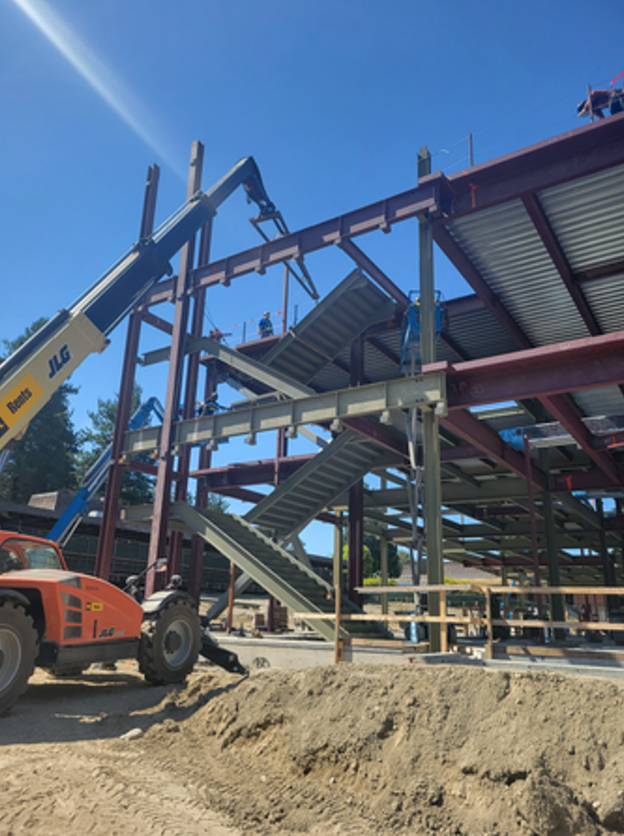

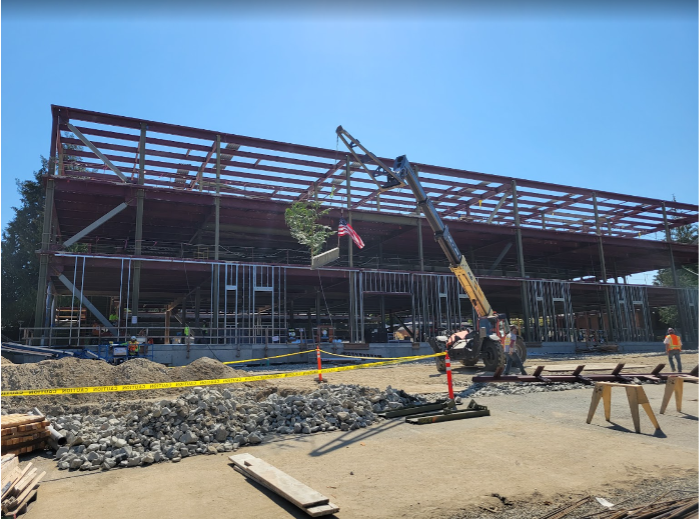

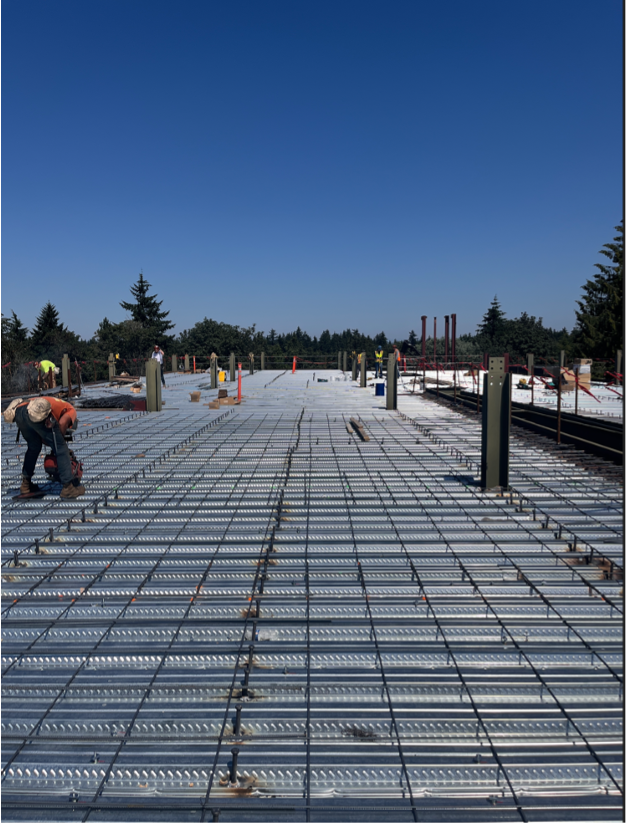

- Major structural steel members were installed up through Level 3 and the
- Next few months the project will continue to work on finishing up metal framing and beginning the exterior sheathing. The next big milestones for the months ahead include:
- Roof structure completion.
- Exterior finishes.
- Dry-In of floors L1, L2, and L3. This will kick off interior scopes of work.
- The critical path and the completion date tracking for a Summer/Fall 2023 building completion.
- Notices regarding road closures, loud work, shutdowns, or interruptions continue to be shared with the Faculty and Staff, and the College’s campus neighbors.
